Construction & InfrastructureInnovation
London's 25km Thames Tideway Tunnel has begun operating, with the first four of its 21 sites switched on and 589,000m3 of sewage captured during heavy rain on 23 September 2024.
London’s ambitious 25km “super sewer,” the Thames Tideway Tunnel, has reached a major milestone: The first four of its 21 sites have been switched on.[1]
This marks the beginning of a new era for the River Thames, which will soon benefit from significantly reduced sewage pollution. The £4.5 billion project,[2] under construction since 2016,[3] is designed to intercept, store and ultimately transfer the raw sewage and rainwater that currently overflows into the River Thames during heavy rainfall. London’s Victorian-era sewer system, built in the 1860s by visionary engineer Sir Joseph Bazalgette, cannot handle the city’s growing population and urbanization demands. This results in millions of tonnes of untreated sewage spilling into the iconic river yearly.
Bazalgette’s original design included a network of interceptor sewers that collected both sewage and rainwater, with a series of combined sewer overflows (CSOs) acting as relief valves during heavy rainfall. While innovative, the system became overwhelmed as London’s population more than doubled in the 150 years that followed.[4] On average, 39 million tonnes of untreated sewage enter the river annually.[5]

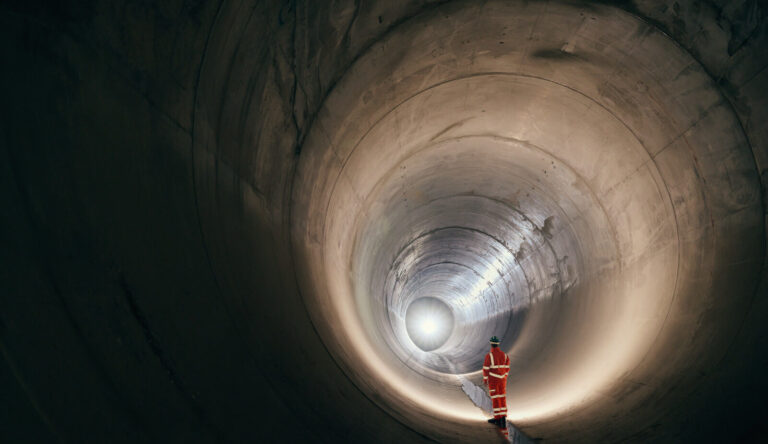

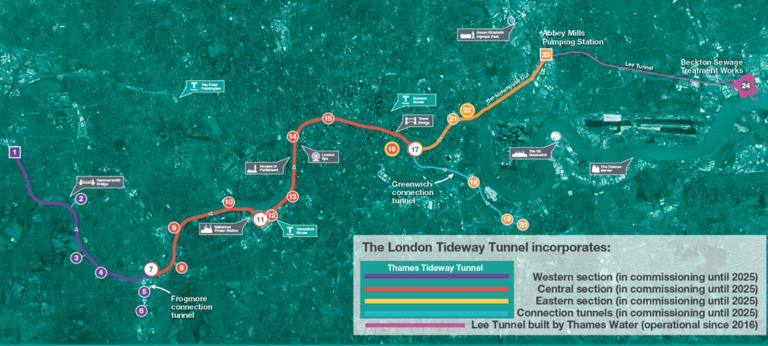

The Thames Tideway Tunnel, spanning from Acton in the west to Abbey Mills in the east, will capture this overflow through a network of shafts and transfer it to Beckton Sewage Treatment Works for processing. With a 7.2m internal diameter[6] and depths of up to 70m,[7] this massive engineering project is set to drastically improve the water quality and ecological health of the Thames, bringing it closer to its state in the late 1800s.
The tunnel is the final piece of a three-part solution known as the London Tideway Improvements. The first part, the 6.9km Lee Tunnel,[8] was completed in 2016,[9] capturing sewage from the city’s largest CSO at Abbey Mills Pumping Station. The second part involved upgrading London’s main sewage treatment works to increase capacity and treatment standards.
The Thames Tideway Tunnel is an engineering marvel. The main tunnel spans 25km, with an internal diameter of 7.2m, running at depths of up to 70m. It will intercept sewage from 34 of the most polluting Combined Sewer Overflows (CSOs).[10][11]

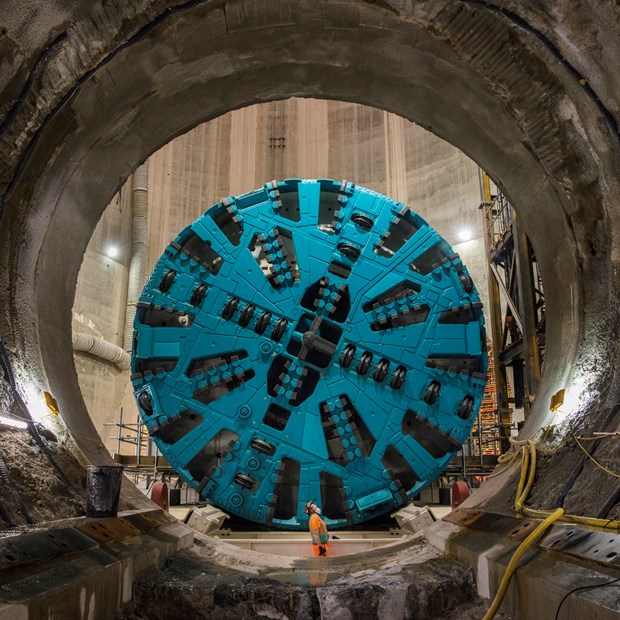

Construction required the use of six tunnel boring machines (TBMs):[12]
Twenty-one shafts were constructed along the route to divert sewage flows and lower the TBMs into the ground.[16] As the TBMs progressed, they installed precast concrete segments to form the tunnel walls. The deepest shaft reaches down to 70m.[17]
The project also includes upgrades to London’s sewage treatment infrastructure. Key improvements were made at Mogden, Crossness, Beckton, Riverside, and Long Reach sewage treatment works to increase capacity and treatment quality.
With the first connections activated, data shows the tunnel captured 589,000m3 of sewage during heavy rainfall on September 23rd.[18][19] The system’s impact will grow as the remaining sites come online in the coming months.
Stakeholders have praised the progress. Tideway CEO Andy Mitchell called it “an important moment for the Thames,” noting that while there are “more connections to make and further testing to come,” the tunnel’s “positive influence on the health of the Thames will increase over the coming months.”[20]
The Thames Tideway Tunnel is expected to be fully operational in 2025,[21] when it should virtually eliminate the harmful effects of sewage pollution on the river.[22]
The tunnel’s impact extends beyond improving water quality. It has also created jobs, with almost 25,000 people contributing more than 40 million working hours over eight years of construction.[3] Furthermore, the project includes building new public spaces along the river, with landscaped embankment areas for community use.
Of course, the project has not been without controversy. Concerns have been raised about the cost, which will be funded through increases in London households’ water bills, and the disruption caused by construction in densely populated areas of the city.
Despite these challenges, the Thames Tideway Tunnel should be a significant step forward in protecting one of London’s most iconic natural assets. As the city’s grows, this infrastructure project will be critical in maintaining a cleaner, healthier River Thames. It showcases British engineering capability and underscores a commitment to environmental stewardship in the heart of the nation’s capital
